Do I need planning permission for solar panels in the UK
By Dr Kilowattsons
Published: 2026-02-26 23:42:59
Updated: 2026-03-10 05:41:15
Understand solar panel planning permission uk in the UK, with clear explanations, examples, and practical next steps.
Key definitions in plain English
The following points summarise the most important takeaways:
DNO approval
Permission from the Distribution Network Operator to connect your system to the electricity network under the relevant process.Conservation area
An area protected for its special architectural or historic interest, with extra controls on external changes.Article 4 direction
A local rule that removes some permitted development rights in a defined area.Planning permission
Approval from your local planning authority for development that is not automatically allowed.Permitted development
A set of rules that allow certain home improvements without applying for planning permission, if conditions are met.Listed building consent
Separate consent required for works that affect a listed building.
When solar panels are usually permitted development
Most domestic roof-mounted solar PV is permitted development when it stays within size and placement limits and is fitted to reduce visual impact where practical. This is most straightforward on typical pitched roofs that do not face extra restrictions. The physical shape and placement of the array matters more than the system size in kW. If you are comparing options by roof size, panel dimensions, and output assumptions, the solar PV comparison tool helps you check like for like inputs.
Common UK limits that can trigger permission
The following points summarise the most important takeaways:
Flat roof height
Panels should not be higher than 1 metre above the roof surface.Wall-mounted panels
Panels should not project more than 200mm and should not be higher than the highest part of the roof.Highest part of roof
Panels should not be installed above the highest part of the roof, excluding chimneys.Flat roof edge setback
Panels should be at least 1 metre from the external edge of a flat roof.Pitched roof projection
Panels should not project more than 200mm from the roof surface.
Listed buildings and heritage areas
Listed buildings typically require listed building consent for solar panels, even if similar works would be permitted development elsewhere. Conservation areas can still allow solar, but location on the building matters more, especially for walls or elevations facing a road. In National Parks and Areas of Outstanding Natural Beauty, ground-mounted systems are more likely to face tighter controls due to visual impact. If you are not sure whether your building is listed or in a designated area, your council planning map usually shows the designations.
Ground-mounted solar in gardens
Small ground-mounted arrays can be permitted development if they stay within size and placement rules. Ground arrays are more likely to need planning if they are large, close to boundaries, or visible and contentious. Glint and glare, visual impact, and neighbour amenity can be considered by planning officers for proposals that need an application.
Planning permission vs lawful development certificate
A lawful development certificate is not the same as planning permission. It is evidence that the work is lawful under permitted development, which can reduce risk during conveyancing and mortgage checks. Some homeowners choose a certificate when the installation is borderline, or when they want written confirmation for future property sale.

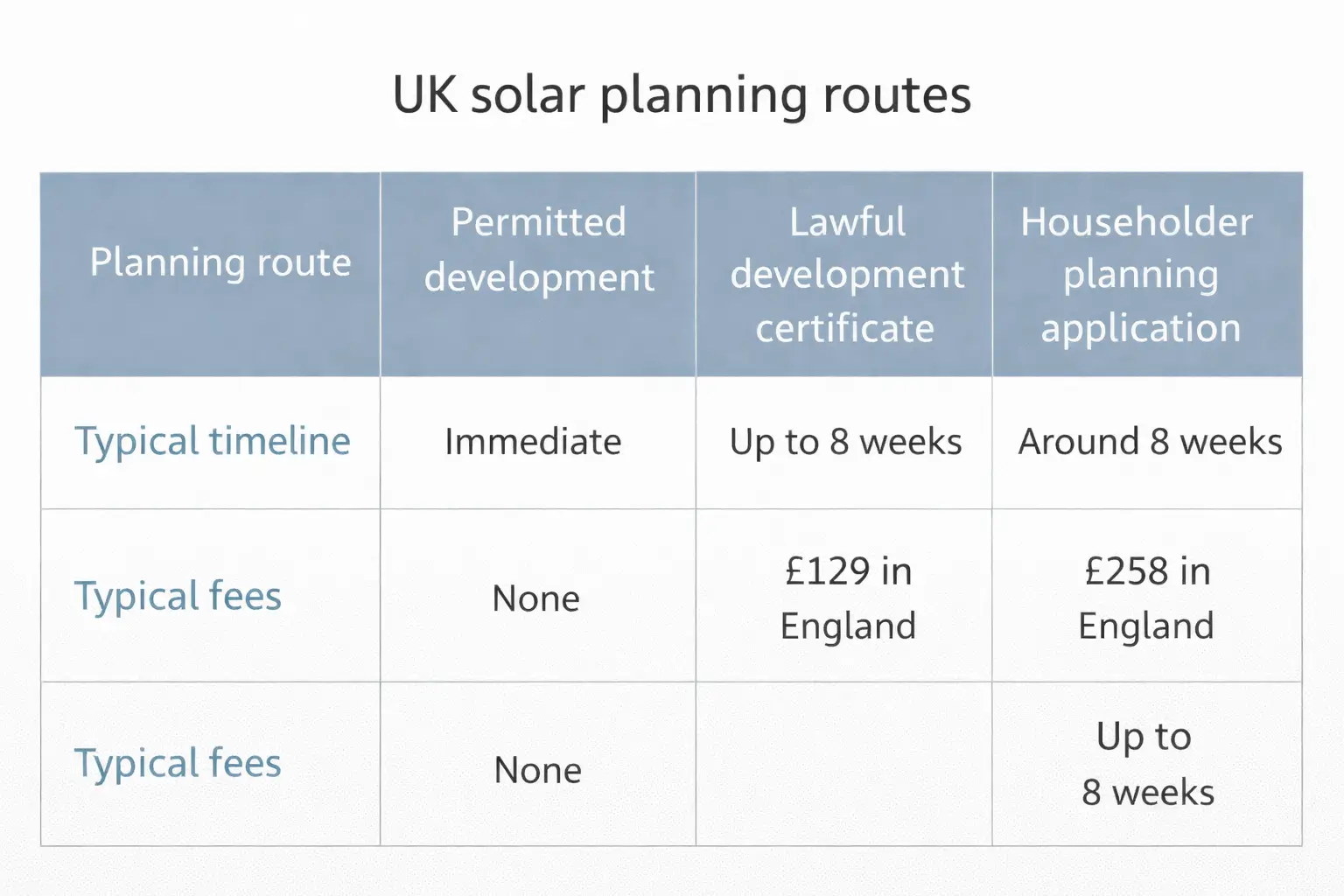

Typical timelines and fees if you need to apply
The following points summarise the most important takeaways:
Permitted development
No planning application, but you still need to comply with limits and any local restrictions.Lawful development certificate
Optional application used as proof, often chosen for certainty during future sale or if designations apply.Householder planning application
Used when limits are exceeded or rights are removed, with typical determination around 8 weeks for straightforward cases.
Practical installer notes homeowners often miss
The following points summarise the most important takeaways:
Part P compliance
Electrical work must comply with regulations and should be certified appropriately.Roof structure check
Installers should check rafter condition and spacing, roof covering condition, and wind exposure before final design.Fixing method matters
The mounting system and fixing points affect weatherproofing risk and structural loading on older roofs.Leasehold constraints
Freeholder permission and roof rights can block an install even if planning rules allow it.DNO process is separate
Grid connection approval can affect export limits even when planning is not required.Metering and monitoring
Export readings and monitoring setup affect what data you can provide to suppliers and how you verify performance.Cable routes affect scope
Inverter location, loft access, and consumer unit position can change drilling, trunking, and labour time.Fire safety and isolators
DC and AC isolator placement and labelling should be planned for safe maintenance and emergency access.
Common misconceptions and objections
The following points summarise the most important takeaways:
Conservation areas ban solar
Solar is often possible, but placement and visibility can change what is allowed.Bigger kW always means planning
Physical projection, height, and location are what typically matter under permitted development.DNO approval is planning permission
DNO approval is about grid connection and export, not planning rules.All solar panels need planning permission
Many domestic roof installs do not, if they meet permitted development limits.Replacing old panels always needs a new permission
Like for like replacement often remains permitted development if limits are still met and local rights have not changed.
Suitability and edge cases
The following points summarise the most important takeaways:
Complex roofs
Dormers, mansards, or roofs with multiple elevations can make it harder to stay within limits and avoid sensitive faces.Garden arrays
Larger ground-mounted systems are more likely to require planning than roof-mounted panels.Typical houses
Detached, semi-detached, and terraced homes often fit permitted development rules for roof-mounted systems.Flats and shared roofs
Permissions can be more about lease terms and shared ownership than about planning.Homes in Article 4 areas
You may need a planning application even for standard installs if rights are removed locally.
